Here's the truth most DC homeowners don't expect: getting solar panels installed takes about a day. Getting permission to turn them on takes months.
If you've heard that a DC solar permit process can stretch 3–6 months from signed contract to a working system, that's accurate — and the delay has almost nothing to do with the physical installation. It's the paperwork. Specifically, two separate bureaucratic approval tracks that have to run their course before your system can legally connect to the grid.
This guide breaks down exactly what those tracks are, how long each step takes, what DC's new GRID Act means for homeowners, and what City Renewables handles on your behalf.
Why Does Solar Take So Long? (Permitting Is the Bottleneck)
When people imagine installing solar, they picture the physical work: a crew showing up, panels going on the roof, wires getting connected. That part takes one to two days.
What actually consumes the timeline is the permitting and interconnection approval process — specifically:
- DCRA (DC's Department of Consumer and Regulatory Affairs) must approve a building permit before any structural work begins.
- Pepco must approve an interconnection agreement before the system can connect to the grid and actually run.
Neither of these is instant. DCRA reviews typically take 2–6 weeks. Pepco interconnection has historically been the longer bottleneck — anywhere from 4 to 12 weeks, and sometimes more.
Both tracks run somewhat in parallel, but you generally can't get a final "Permission to Operate" (PTO) from Pepco until your DCRA permit is issued, the physical installation is complete, and the system passes inspection. The whole process, from contract signing to a working system, typically runs 3–6 months in DC.
Understanding this timeline upfront prevents frustration. The wait isn't a sign something went wrong — it's just how DC solar permitting works.
The Two Permit Tracks: DCRA + Pepco Interconnection
Track 1: DCRA Building Permit
DCRA issues building permits for the structural and electrical work involved in a solar installation. This covers the mounting hardware, roof penetrations, and the electrical components connecting the system to your home's panel.
For most DC residences, a DCRA solar permit takes 2–6 weeks from application submission to approval. The permit application includes:
- Structural engineering drawings showing how the racking attaches to the roof
- Electrical diagrams for the system components
- Site plans and roof layout
Once the installation is complete, DCRA also sends an inspector to verify the work was done according to the approved plans. That inspection must be passed before Pepco will issue the final Permission to Operate.
DCRA's building permit portal is at dcra.dc.gov ↗. City Renewables submits all permit applications on your behalf — you'll never need to navigate that portal yourself.
Track 2: Pepco Interconnection Agreement
Every solar system connected to the grid must be reviewed and approved by the utility — in DC, that's Pepco. This is called the interconnection application process.
Pepco evaluates your system's proposed size and location against the local grid's capacity to handle additional generation. They also require detailed technical documentation about your inverter, system specifications, and installation plans.
Historically, Pepco interconnection has been the primary bottleneck in DC solar projects. A complete, accurate application can take 4–8 weeks. Incomplete applications requiring back-and-forth with Pepco can easily stretch to 10–12 weeks or longer.
Common causes of Pepco delays:
- Missing or incorrect technical documentation at submission
- Grid capacity reviews that require additional engineering analysis
- High application volume creating queue delays
Pepco's interconnection information is available at pepco.com ↗ and the DC Public Service Commission at psc.dc.gov ↗. Again — City Renewables manages the entire Pepco application process.
For a deeper dive on Pepco's approval process specifically, see our guide to Pepco's solar approval process.

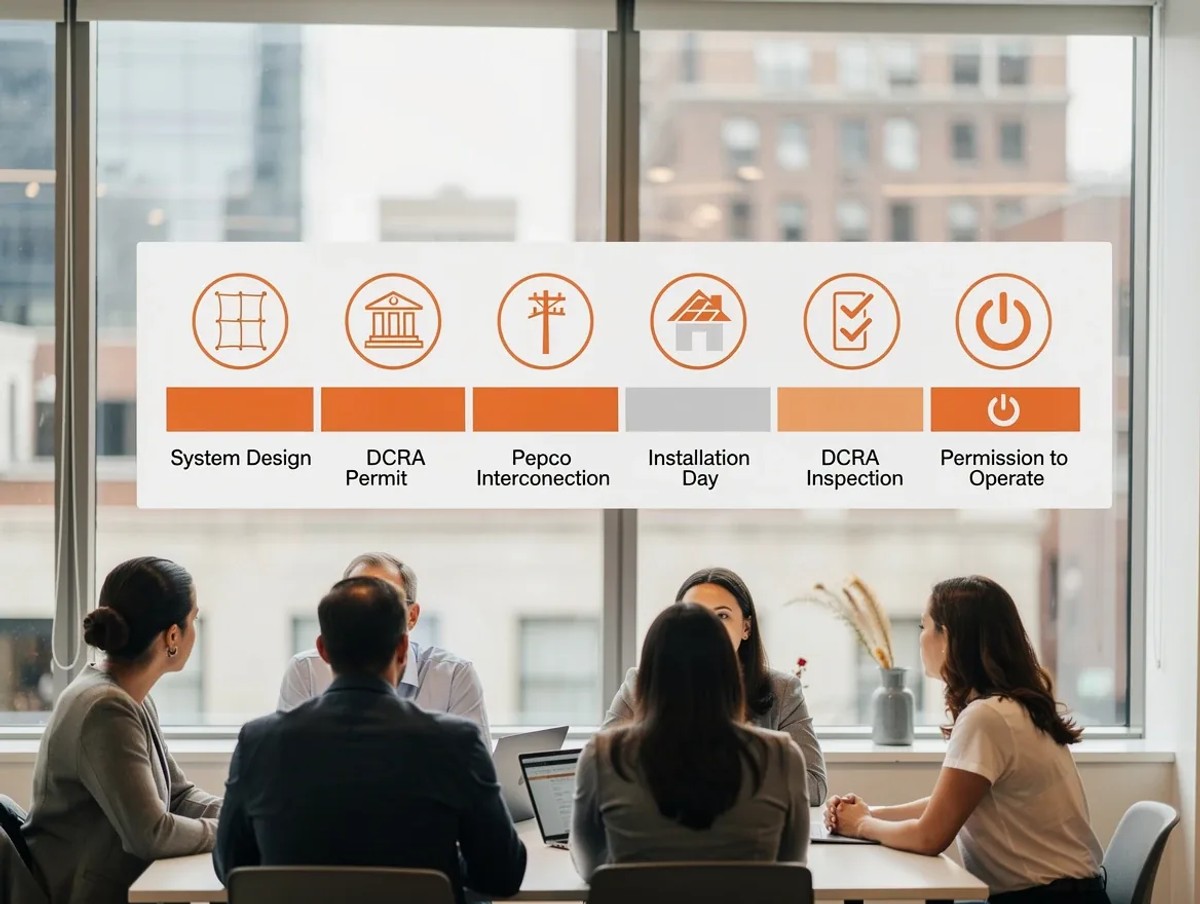

Step-by-Step: DC Solar Permitting Timeline
Here's how a typical DC solar project flows from contract to a working system.
| Phase | What Happens | Typical Duration |
|---|---|---|
| 1. System Design | Engineering site visit, roof assessment, system design, permit application prep | 2–4 weeks |
| 2. DCRA Permit Submission | Building permit application submitted to DCRA | Submitted in week 3–5 |
| 3. DCRA Permit Approval | DCRA reviews application, issues building permit | 2–6 weeks after submission |
| 4. Pepco Interconnection Application | Application submitted to Pepco (often simultaneous with DCRA) | Submitted in week 3–5 |
| 5. Pepco Review | Pepco evaluates grid capacity, reviews technical docs | 4–12 weeks |
| 6. Installation Day | Physical installation (panels, racking, inverter, wiring) | 1–2 days |
| 7. DCRA Inspection | Inspector verifies installation matches approved plans | 1–2 weeks after installation |
| 8. Pepco Permission to Operate (PTO) | Pepco issues PTO; system is switched on; net metering begins | Days to weeks after inspection |
Total: 3–6 months from contract signing to a working system.
The widest variable is Pepco's interconnection review. Projects with complete, accurate applications — submitted by an experienced installer — consistently run at the shorter end of that range. Projects with missing documentation or grid capacity issues can push toward 5–6 months or beyond.
For more on how the system design phase affects your overall project schedule, see our guide to how system design impacts your project timeline.

Historic Homes and Row Houses: Extra Considerations
DC has more historic-designated properties than almost any other American city. If your home is in a historic district or is a landmark property, solar permitting involves an additional review layer.
Historic Preservation Review
The DC Historic Preservation Office (HPO) reviews solar installations on properties subject to historic preservation controls. For row houses and properties in districts like Capitol Hill, Georgetown, Dupont Circle, Kalorama, and others, this review determines whether the proposed installation is appropriate given the historic character of the building and streetscape.
HPO review typically focuses on:
- Visibility from the public right-of-way (panels should be minimally visible from the street)
- Panel placement and mounting approach
- Impact on the historic character of the roof
In most cases, DC's HPO is supportive of solar on historic properties when panels are placed on rear-facing roof slopes or are not visible from the street. Projects that require placing panels on front-facing slopes in highly visible historic districts may require more documentation or design modifications.
Historic preservation review can add 2–6 additional weeks to the DCRA permit process, depending on the complexity of the review and whether an ANC (Advisory Neighborhood Commission) hearing is triggered.
ANC Review
For some historic district projects, particularly those involving larger or more visible installations, the relevant ANC may weigh in. ANC meetings happen on a set schedule, so a missed meeting can add 4–6 weeks to the timeline.
What This Means for Your Timeline
If your home is in a historic district, add 4–8 weeks to the typical permitting timeline as a buffer. The final outcome is almost always approval — but the process takes longer.
City Renewables handles historic preservation applications and ANC coordination. If you're in a historic district, we'll tell you upfront what to expect.
See our dedicated guide to solar panels on DC row houses for more detail on structural and design considerations specific to DC's rowhouse stock.
The GRID Act: DC Council's Push to Speed Things Up
In February 2026, the DC Council introduced the GRID Act — legislation specifically aimed at accelerating the solar interconnection process with Pepco.
What the GRID Act Proposes
The GRID Act targets the Pepco interconnection bottleneck directly. Key provisions include:
- Response time requirements: Pepco would be required to respond to interconnection applications within defined timeframes, reducing the open-ended waiting that currently frustrates homeowners and installers alike.
- Streamlined review for smaller systems: Residential rooftop solar systems below a certain size threshold would qualify for a simplified, faster review track.
- Penalties for non-compliance: Utilities that miss mandated response windows could face consequences, creating real accountability.
- Transparency requirements: Homeowners and installers would have clearer visibility into where their application stands in the queue.
Current Status
As of April 2026, the GRID Act is active legislation moving through the DC Council. It has not yet been enacted into law. The DC Public Service Commission, which oversees utility regulation in the District, is involved in the rulemaking discussions.
Industry observers are cautiously optimistic. The bill has broad support from clean energy advocates and has been framed as consistent with DC's clean energy goals (100% renewable electricity by 2032). But legislative timelines are uncertain — implementation rules, if passed, would take additional months to go into effect.
What This Means for You Right Now
If you're planning a solar installation today, plan your timeline around current Pepco processes — not the GRID Act's potential improvements. Don't wait for the legislation to pass before starting. The permitting process begins the moment your installer submits your application, and starting sooner is always better.
If the GRID Act passes and shortens interconnection timelines, that's an upside benefit for projects already in the queue. It doesn't give a reason to delay.
What City Renewables Handles for You
One of the most common misconceptions about solar is that the homeowner has to manage the permit process. You don't.
City Renewables manages the entire permitting and interconnection process on your behalf, from start to finish. Here's what that includes:
System design and permit prep
- Engineering site visit and roof assessment
- Structural and electrical drawings for DCRA submission
- System specifications and inverter documentation for Pepco
DCRA permit management
- Application submission to DCRA
- Responding to any documentation requests during review
- Scheduling the post-installation inspection
Pepco interconnection management
- Complete interconnection application submission
- Coordination with Pepco on any technical questions or revisions
- Tracking application status and following up proactively
Historic preservation coordination (if applicable)
- HPO application and documentation
- ANC coordination for projects requiring it
SREC registration
- After Pepco issues your Permission to Operate, your system is registered through DC's Department of Energy and Environment (DOEE) via PJM-GATS
- This is how your SREC income gets set up — City Renewables handles the registration
For a deep dive on Pepco's net metering program and how credits work once your system is live, see our Pepco net metering guide.
Your job as the homeowner: show up on installation day. We handle everything else.
Frequently Asked Questions
How long does the DC solar permitting process take?
For most DC homes, the full process from contract signing to a working system takes 3–6 months. The main variables are Pepco's interconnection review timeline (4–12 weeks is typical) and whether your home requires historic preservation review (add 4–8 weeks if so). The physical installation itself takes just 1–2 days — the timeline is almost entirely permitting.
Does my DC row house require extra permits for solar?
All DC solar installations require both a DCRA building permit and a Pepco interconnection agreement. If your row house is in a historic district (Capitol Hill, Georgetown, Kalorama, and others), you'll also need historic preservation approval from the DC Historic Preservation Office. This adds time but rarely prevents installation — the outcome is almost always approval when panels are placed on rear-facing slopes or are not prominently visible from the street. City Renewables handles all of this for you. See our Capitol Hill solar installation guide for neighborhood-specific details.
What can delay a DC solar project beyond 6 months?
The most common causes of extended delays are: (1) incomplete or inaccurate Pepco interconnection applications that require multiple rounds of revision; (2) grid capacity issues at the transformer level that require additional engineering review; (3) historic district projects that trigger ANC review processes; and (4) DCRA permit review queues during high-volume periods. Working with an experienced DC installer who submits complete, accurate applications from the start is the single best way to minimize delays.
Can I get solar if my HOA or condo association has restrictions?
DC law generally protects homeowners' right to install solar, but HOA and condo association rules can create additional complexity — particularly regarding aesthetics and common-area roof access. If you're in a condo or have an HOA, contact us before signing anything. We'll assess what approvals are needed and whether your specific situation is workable. Book a consultation to talk through the details.
Conclusion
The DC solar permitting process is not fast — but it is predictable, manageable, and worth it.
The 3–6 month timeline surprises most homeowners until they understand that the bottleneck is bureaucratic, not physical. DCRA permits take time. Pepco interconnection takes more time. Historic preservation adds time on top of that for many DC neighborhoods. But none of these are obstacles — they're just steps in a process.
The GRID Act represents a genuine effort by DC Council to compress Pepco's interconnection timeline. If it passes, future DC solar projects could be meaningfully faster. For projects starting today, the current process applies — and starting sooner means your system comes online sooner.
City Renewables handles every permit, every application, and every follow-up call with Pepco on your behalf. You don't need to understand the regulatory landscape — that's what we're here for.
Ready to find out if your home qualifies? Check your address with our free GreenZone assessment — we'll show you your roof's solar potential, estimated savings, and a realistic project timeline based on your specific neighborhood and home.
